Project Overview
The Bartlett Street Reconstruction Project is complete.
The project included the reconstruction of underground public utilities (water, sewer, and drainage) on Bartlett Street from Hodgdon Brook to Dennett Street and on Thornton Street from Woodbury Avenue to Bartlett Street. The work also included connections to existing utilities on the side streets of Morning Street, Clinton Street, Pine Street, Meredith Way, and Woodbury Avenue.
The project also included reconstruction of the streetscape, including curbing and sidewalks, roadway reconstruction, and the installation of traffic calming measures.
Project Details
- Start: April 9, 2024
- Substantial Completion: November 15, 2024
- Final Completion: June 30, 2025
- Estimated Construction Cost: $4,600,000 (est)
- Design Engineer: DPW In-House Staff
- Contractor: Albanese D&S, Inc.

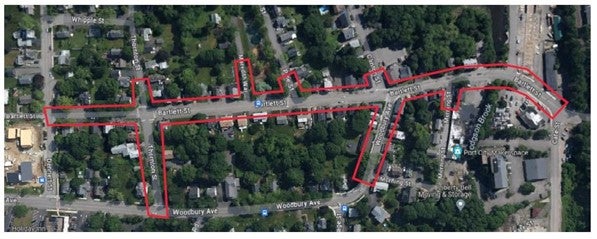

Area of Impact
Project Updates
Status Update: Jun 30, 2025
Project Completed: June 30, 2025
Project Documents
This section includes project drawings, meeting materials, and traffic data related to Bartlett Street, Thornton Street, and nearby roundabout and traffic calming studies.
Plans, Drawings, Maps & Surveys
- Project Drawings - Issued for Construction Set Mar 21, 2024
Meeting Material (Agendas, Minutes and Presentations)
- Project Meetings: - Public Preconstruction Meeting Mar 27, 2024
- Project Meetings: - Traffic Calming Designs Meeting Nov 8, 2023

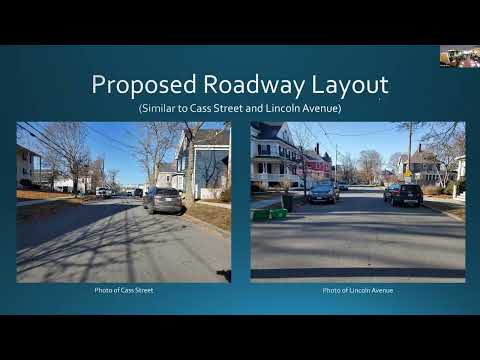

- Project Meetings - Public Information Meeting Dec 8, 2022
- Project Meetings - Public Input Meeting Dec 9, 2021
Documents, Reports & Studies
- Bartlett St. Roundabout Through Movement Speed Data Summary May 13, 2023
- Bartlett St. at Roundabout Detailed Through Movement Speed Data May 11, 2023
- 390 Bartlett St., Speed Data Analysis Jul 5, 2023
- Bartlett at Roundabout Speed Data Analysis Jun 29, 2023
- All-way stop - Bartlett at Thornton Aug 23, 2022
- 2023 Roundabout - Bartlett at Thornton May 16, 2023
- Bartlett Roundabout Concerns Jun 1, 2026
Project Video
Project FAQ
What was the Bartlett Street Reconstruction Project?
The Bartlett Street Reconstruction Project rebuilt infrastructure and the roadway along Bartlett Street from Hodgdon Brook to Dennett Street, as well as Thornton Street from Woodbury Avenue to Bartlett Street. The work replaced aging underground utilities and reconstructed the street to improve reliability, safety, and accessibility for residents and roadway users.
What improvements were completed during the project?
The completed project included several infrastructure and roadway improvements, including:
- Replacement of water mains
- Replacement of sanitary sewer infrastructure
- Installation of stormwater drainage improvements
- Reconstruction of the roadway surface
- Installation of new curbing and sidewalks
- Updated pavement markings and traffic signage
These upgrades modernized underground utilities while improving pedestrian and roadway infrastructure along the corridor.
When was the project constructed?
Construction began in April 2024. The work progressed through 2024 with roadway reconstruction, utility installation, and related improvements. The project reached substantial completion in November 2024, with final restoration and close-out activities completed in 2025.
What traffic changes were made at the Bartlett Street and Thornton Street intersection?
As part of the reconstruction, the intersection of Bartlett Street and Thornton Street was reconfigured. The intersection now operates as a two-way stop, with stop signs located on Thornton Street while Bartlett Street traffic continues through the intersection.
How does the completed project benefit the neighborhood?
The completed project provides several long-term benefits for the surrounding neighborhood, including:
- Replacement of aging underground utilities
- Improved stormwater drainage
- New sidewalks and pedestrian infrastructure
- Reconstructed roadway and curbing
- Updated traffic control features
These improvements help ensure reliable infrastructure and safer travel conditions for residents, pedestrians, and motorists.
